>> Click Here for Further Information about the Almaden Lake Improvement Project >>
This project helps restore and maintain healthy fish populations, especially steelhead, by improving fish passage and habitat. Sites may include Alamitos Creek at Almaden Lake and County of Santa Clara-owned Ogier Ponds, where humanmade creek alterations disrupt fish migration. Project D4, which includes coordinating and partnering with other external parties, incorporates studies of streams throughout the county to determine what and where habitat improvements will most benefit steelhead. These studies can be used by regional partners to implement complementary habitat enhancements.
The project also continues funding to place instream gravel, boulders, large wood, or other features to enhance fish habitat at appropriate locations. By adding natural stream features such as large wood, we can create habitat to provide refuge during fish migration, prolonged drought, or extreme rainfall events. Additionally, habitat restoration can improve ecosystem function and increase resiliency to climate change. By restoring natural functions, issues such as water quality may be less exacerbated and native species can continue to flourish and adapt.








Project Modification: January 2023
On January 24, 2023, the Valley Water Board of Directors (Board) held a formal public hearing and approved modifying KPI#2 to “Partially fund the construction of one (1) creek/lake separation project in partnership with local agencies.” The modification was necessitated due to construction cost escalations across the Safe, Clean Water Program impacting the program’s financial health.
The Board also changed the project selections for KPI #1 and KPI #2. The Board selected the Almaden Lake Improvements Project to deliver KPI #1 to complete planning and design for one (1) creek/lake separation. Since previously selecting the Almaden Lake Improvements Project to be constructed under KPI #2 in 2021, Almaden Lake Improvements Project construction cost estimates have nearly tripled, making project construction unfeasible. As a result, the Board selected the Ogier Ponds Project to deliver KPI #2 to partially fund the construction of one (1) creek/lake separation project in partnership with local agencies. The Ogier Ponds Project is now part of the Anderson Dam Seismic Retrofit Project (ADSRP) as a mitigation measure to help offset some of that project’s impacts. As part of ADSRP, the Ogier Ponds Project construction is funded by more sources than just the Safe, Clean Water Program, which helps reduce the financial impact on the Safe, Clean Water Fund.
See Environmental & Community Benefits section for complete description of Key Performance Indicators (KPIs).
KPI #1: (Planning, design for creek/lake separation)
Almaden Lake:
- On May 11, 2021, the Board certified the Final Environmental Impact Report. Click here to read the report.
- The planning phase of the project was completed in 2019. Valley Water is in the process of closing out the 60% design plans and specifications for the Almaden Lake Improvement Project.
KPI #2: (Partially construct creek/lake separation)
Ogier Ponds:
- A Master License Agreement (MLA) to facilitate Valley Water’s access and planning study investigations on Santa Clara County Parks land is in development.
- Preliminary conceptual alternatives development for the planning study is underway.
- The project is coordinating with the Anderson Dam Seismic Retrofit (ADSRP) project team to include the project in ADSRP permitting.
- Design is expected to begin in spring 2024.
- Construction is to coincide with ADSRP completion (currently 2032).
KPI #3: (Fish passage improvements)
In October 2021, the City of San José, in partnership with Valley Water, completed the construction of a new interim pedestrian bridge, replacing the Singleton Road low-water crossing at Coyote Creek. Valley Water Board approved the cost-share agreement in June 2021 and in July 2021, Valley Water provided $1.0 million in cost-share funding to the city for construction. Valley Water also provided the city with project design services and permitting assistance. The low-water crossing was a barrier to fish passage and its removal increased migratory fish access to about 17 miles of upstream Coyote Creek area with better, cold-water habitat. Valley Water will continue to monitor the project until 2031.
KPI #4: (Steelhead stream study update)
In FY22 (July 1, 2021 – June 30, 2022) Valley Water began research to determine which creek sections to target for a new quantitative fish passage barrier and prioritization analysis. Guadalupe Creek, Alamitos Creek and Arroyo Calero were selected, and preparation of the on-call consultant contract is underway to support the prioritization analysis.
Update on the 2012 Program Funded Study: In FY23, Valley Water will complete the second phase of the study to identify high-priority locations for gravel augmentation and large woody debris placement. The second phase covered six steelhead streams in the county, namely Llagas, Pacheco, Los Trancos, San Francisquito and Calero creeks and Pajaro River. The first phase of the study, which was completed in FY18, assessed Alamitos, Guadalupe, Los Gatos, Uvas, Upper Penitencia, Coyote and Stevens creeks and Guadalupe River. Conceptual designs for eight priority sites identified in the second phase study are under development.
KPI #5: (Habitat enhancement projects)
In June 2022, Valley Water began construction of the Uvas Creek Fish Habitat Improvement Project, which includes large woody debris and gravel augmentation (LWDGA) along Uvas Creek in the City of Gilroy. The project was completed in August 2022.

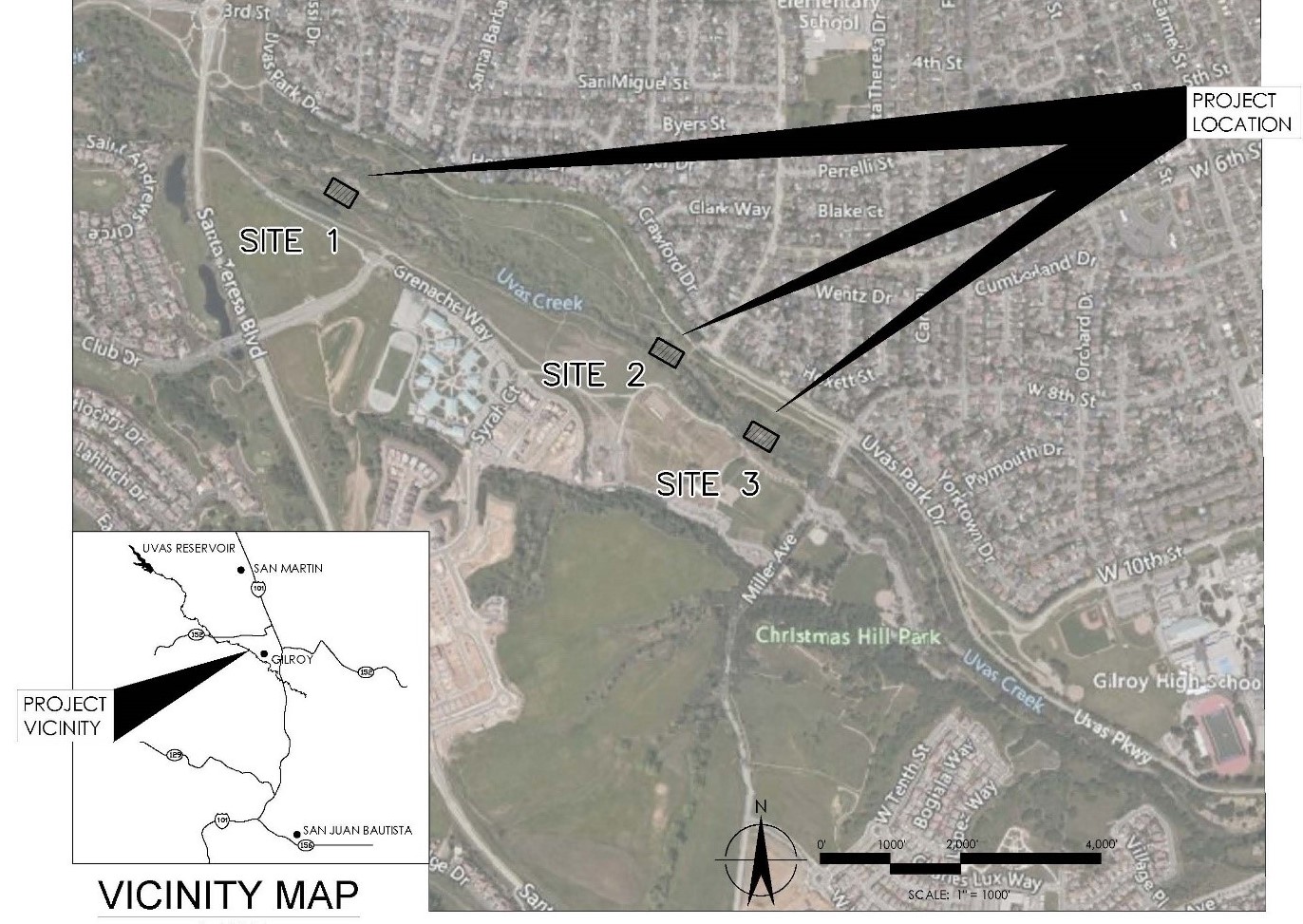

The project was designed to increase instream habitat diversity, shelter complexity and the amount of instream shelter at three sites along Uvas Creek. The design of Site 1, located approximately 1200 feet downstream of Santa Teresa Boulevard, consists of an engineered log jam (ELJ) of rootwad logs on the right bank intended to create hydraulic complexity and increase shelter cover and complexity. The ELJs for Sites 2 and 3, located 1500 feet and 600 feet respectively upstream of Miller Avenue, include a bar apex jam at each site designed to cause channel bifurcation and increase habitat complexity.
Outreach coordination with the City is ongoing, and this project is featured on City’s website: https://ca-gilroy.civicplus.com/860/Outside-Agency-Construction-Projects
March 2023
- Ogier Ponds Feasibility Study (March 2018)
- Study of Major Steelhead Streams – Phase 1 Report
- Almaden Lake Improvement Project Draft Environmental Impact Report (December 2019)
- Almaden Lake Improvement Project Final Environmental Impact Report (May 2021)
>> Information about the Almaden Lake Improvement Project >>
>> Information about the Almaden Lake Improvement Project >>
Key Performance Indicators (FY22-36)
-
Complete planning and design for one (1) creek/lake separation.
-
Partially fund the construction of one (1) creek/lake separation project in partnership with local agencies.
-
Use $8 million for fish passage improvements by June 30, 2028.
-
Update study of all major steelhead streams in the county to identify priority locations for fish migration barrier removal and installation of large woody debris and gravel as appropriate.
-
Complete five (5) habitat enhancement projects based on studies that identify high priority locations for large wood, boulders, gravel, and/or other habitat enhancement features.
Benefits
-
Improves habitat and passage for steelhead and other native fish within Santa Clara County watersheds
-
Contributes to required mitigation for environmental impacts of reservoir and recharge operations and countywide Stream Maintenance Program
-
Maintains investment in earlier habitat improvements
-
Addresses climate change
