E6: Upper Llagas Creek Flood Protection*
Preferred project: A federal-state-local partnership
This project continues a partnership with the U.S. Army Corps of Engineers (USACE) and the State of California to plan, design and construct improvements along 13.9 miles of channel. The project extends from Buena Vista Avenue to Llagas Road and includes West Little Llagas Creek in downtown Morgan Hill. The federally authorized preferred project protects the urban area of Morgan Hill from a 1% flood (100-year event) and reduces the frequency of flooding in surrounding areas. Construction includes channel modifications and replacement of road crossings. Valley Water continues to work with Congress to aggressively pursue federal funds to bring this project to full fruition.
Local-funding-only project
Construct flood protection improvements along Llagas Creek from Buena Vista Avenue to Highway 101 in San Martin (Reaches 4 and 5), Monterey Road to Watsonville Road in Morgan Hill (Reach 7a), approximately W. Dunne Avenue to W. Main Avenue (a portion of Reach 8), and onsite compensatory mitigation at Lake Silveira.
Valley Water begins construction of the final phase
Valley Water began construction on Phase 2B, the final phase of the Upper Llagas Creek Flood Protection Project, in September 2024. This phase includes improvements on approximately eight (8) miles of Upper Llagas Creek, from US 101 upstream to Llagas Road. Phase 2B is scheduled for completion in spring 2027. Once completed, approximately 1,100 homes, 500 businesses, and over 1,300 acres of agricultural land will be protected from the 100-year flood. After the project's completion, a three-year post-construction mitigation native plant revegetation period will follow.
Clicke here to see a video showing completed and on-going work activity. An article about the project was published in the Morgan Hill Times. Click here to read it.
The project began its final season of in-channel construction, which will continue through the end of 2026. This work season includes flood-risk-reduction improvements along approximately 3 miles of West Little Llagas Creek, from Watsonville Road upstream (north) to Llagas Road in Morgan Hill. A copy of this season’s work mailer is available to download, and a video about the work.
West Little Llagas Creek will be widened and deepened from Watsonville Road to Ciolino Avenue and from Hillwood Lane to Llagas Road. Neighborhoods near the creek can anticipate:
- Noise from the large construction equipment, haul trucks, and work crews moves within the creek.
- Dust will be generated by the excavation equipment and when soil is placed in the haul trucks. Water trucks will be used to minimize dust.
- Excavation equipment in use during the day. Trucks will cycle in and out of the creek as they are loaded with excavated material for transport. Road closures are not expected, but flaggers will guide trucks in and out of the creek.
- Public trail closures when work is performed along West Little Llagas Creek Valley Water will monitor noise and dust impacts and take the necessary measures to lessen them. Safety will be a priority as the trucks enter and exit work sites. Please use extra caution when walking or driving near the construction site.
Crews will work Monday through Friday from 7:00 a.m. to 8:00 p.m. and Saturdays from 9:00 a.m. to 6:00 p.m.
Below are details of the temporary road and trail closures.
Hale Avenue from Galvan Park to Llagas Road and Wright Avenue (Closed through October 2026)

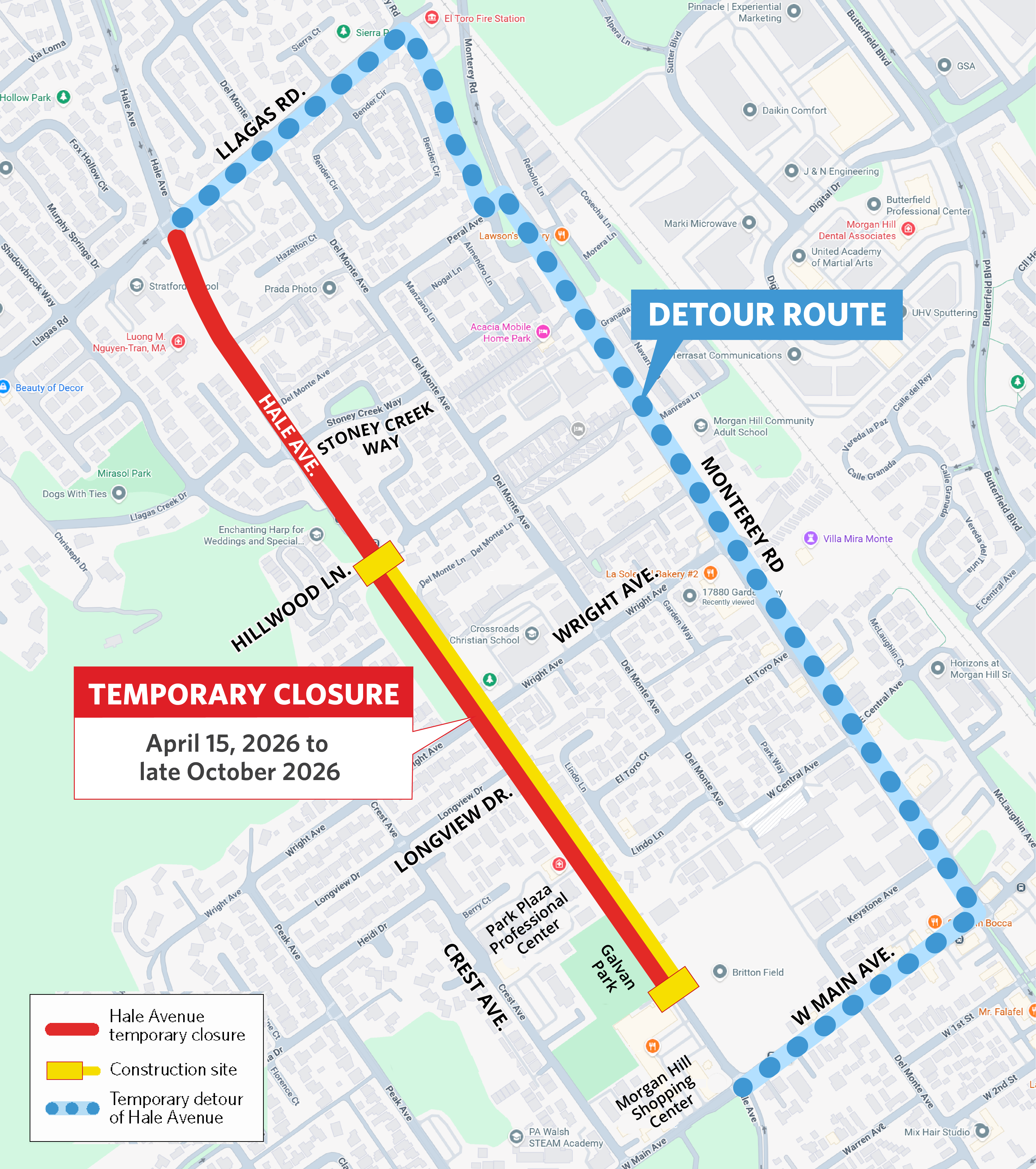

Hale Avenue from Galvan Park to Llagas Road and Wright Avenue will be closed through October 2026.

Crews will focus on utility relocations and the completion of the final 400 linear feet of two twin underground 10ft x 9ft box culverts to replace West Little Llagas Creek at Wright Avenue. These rectangular-shaped boxes serve as underground tunnels designed to convey a 100-year storm event, which has a 1% chance of occurring every year. A proposed sound wall will be constructed on the east side of Hale Avenue south of Wright Avenue, with the underground relocation of overhead utility lines on the west side. Hale Avenue will be widened and restored, with a new curb and gutter installed along the east side.
Temporary Closures of West Little Llagas Trail (through December 2026)

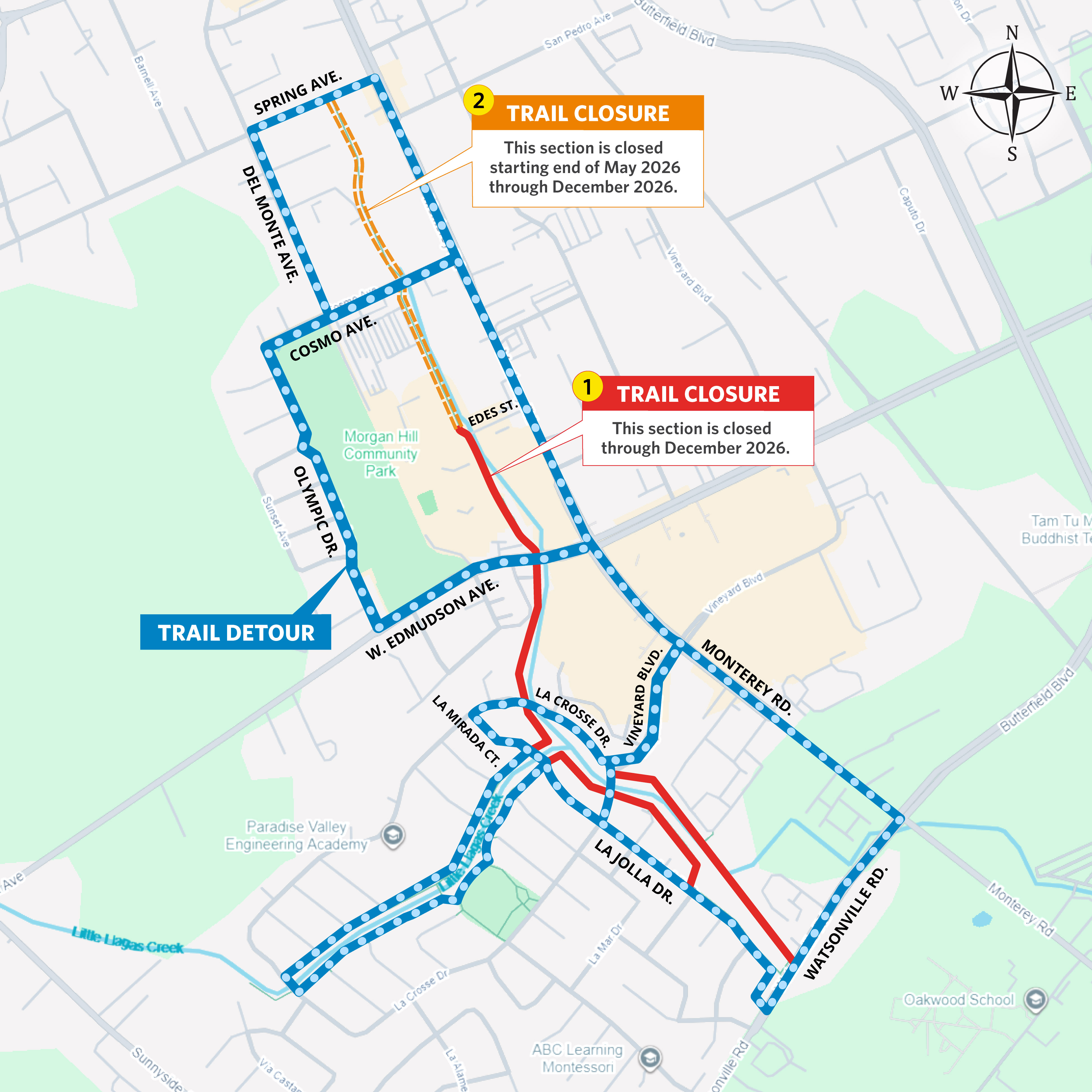

Through the end of the year, the West Little Llagas Creek trail will be closed on both sides of the creek, from Watsonville Road to Edes Street, to accommodate creek widening and deepening activities. The trail section from Edes Street to Spring Avenue will be closed in late summer 2026 to allow crews to complete similar creek work from Edes Street to Ciolino Avenue.
Spring Avenue Closure (June 15th through end of Septe2026)

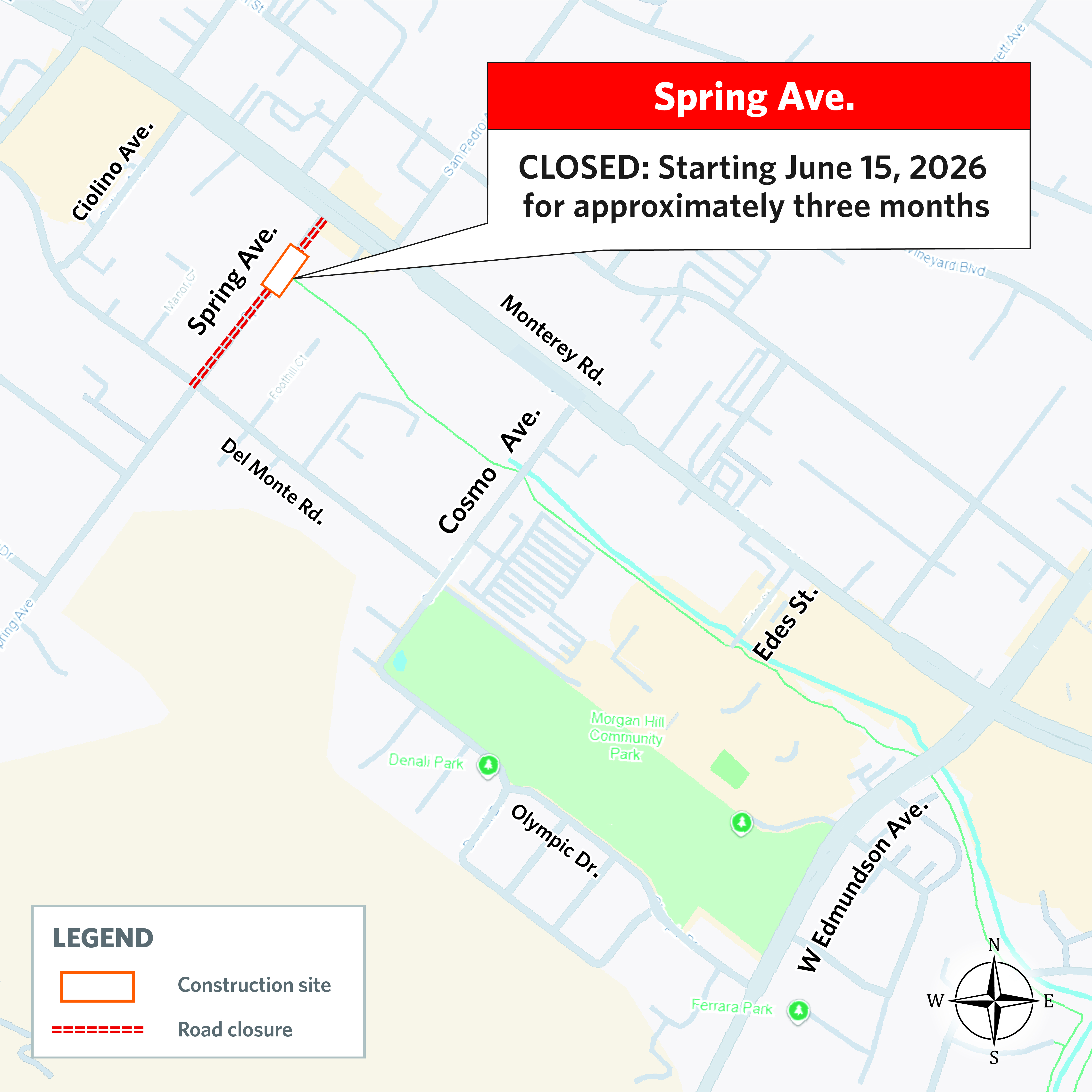

Crews will construct three 10-by-9-foot box culverts beneath Spring Avenue to replace the single, smaller, and under-capacity box culvert that currently conveys stormwater. Valley Water has already improved the creek channel upstream to better convey more stormwater and aims to provide the same update at this location. Spring Avenue will be closed to through traffic (map) at West Little Llagas Creek for three months starting June 15. Traffic headed to Monterey Road will be diverted to W. Dunne, Ciolino, or Cosmo avenues.
Project Information

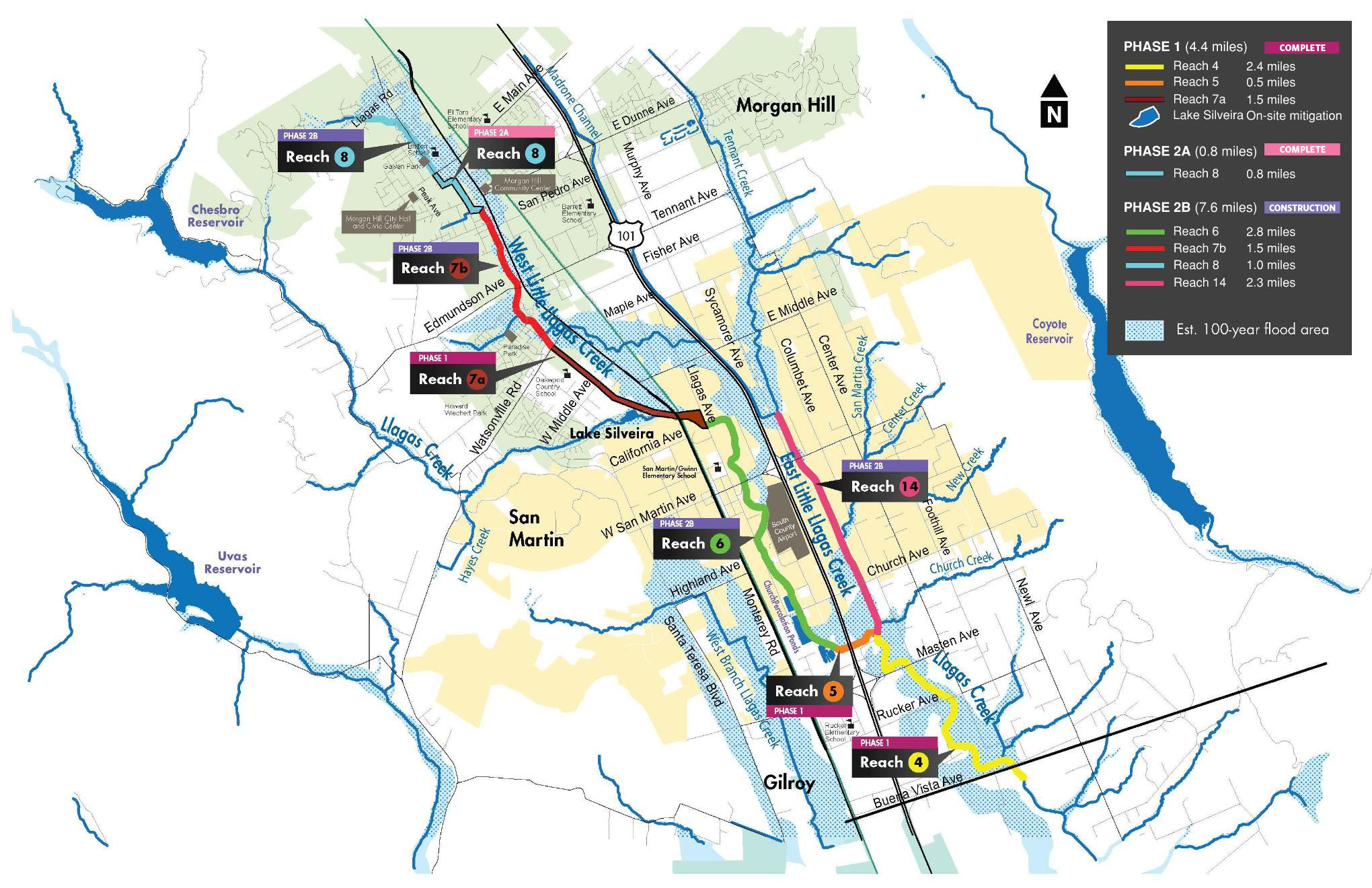

The project is being constructed in several phases, each with specific sections (referred to as reaches on the map) where the proposed improvements will occur. Phase 1 was completed in April 2022, including creating a new wetland habitat at Lake Silveira and planting more than 45,000 native plants along the widened and deepened channel. In August 2024, Valley Water completed Phase 2A of the project, including constructing a 2,300-foot-long tunnel underneath downtown Morgan Hill. The final phase of the project, Phase 2B, is now under construction and expected to be completed in 2027. Details about Phases 1 and 2A are under the History & Background section of this webpage.
The Phase 2B mailer is available with details about the work scheduled for each of the four reaches where construction will occur.
Phase 2B: in construction through spring 2027
Phase 2B construction consists of approximately 1,900 linear feet of twin reinforced concrete box culverts (10 ft x 9 ft), creek modifications and excavation by widening and deepening, installation and modification of culverts at various street crossings, construction of an inlet basin weir split-flow structure to divert high creek flows, and support of existing bridges by underpinning. Valley Water will construct improvements on approximately eight (8) miles of Upper Llagas Creek, from US 101 upstream to Llagas Road. Construction will include creek widening and deepening, bridge/culvert construction, traffic control, utility coordination and relocation, construction of maintenance roads, and habitat enhancements. Construction is expected to be completed in spring 2027.
The Phase 2B mailer is available with details about the work that occurred during the first season of work for this final phase.
Bridge Moved to Allow for Flood Protection Work
Valley Water relocated a pedestrian bridge to make room for major flood protection improvements along West Little Llagas Creek, ensuring both safety and continued trail access for the community. The bridge was moved to Edmundson Creek, near its connection with West Little Llagas Creek. This move enables the bridge to remain part of Morgan Hill’s trail system, providing walkers, joggers and cyclists with a scenic and safe crossing.
